COMMERCIAL EV CHARGINGPerth

EV Charger Load Management in Perth

Any site with limited supply

Load management for Perth commercial sites, so EV charging shares the supply the building already has.

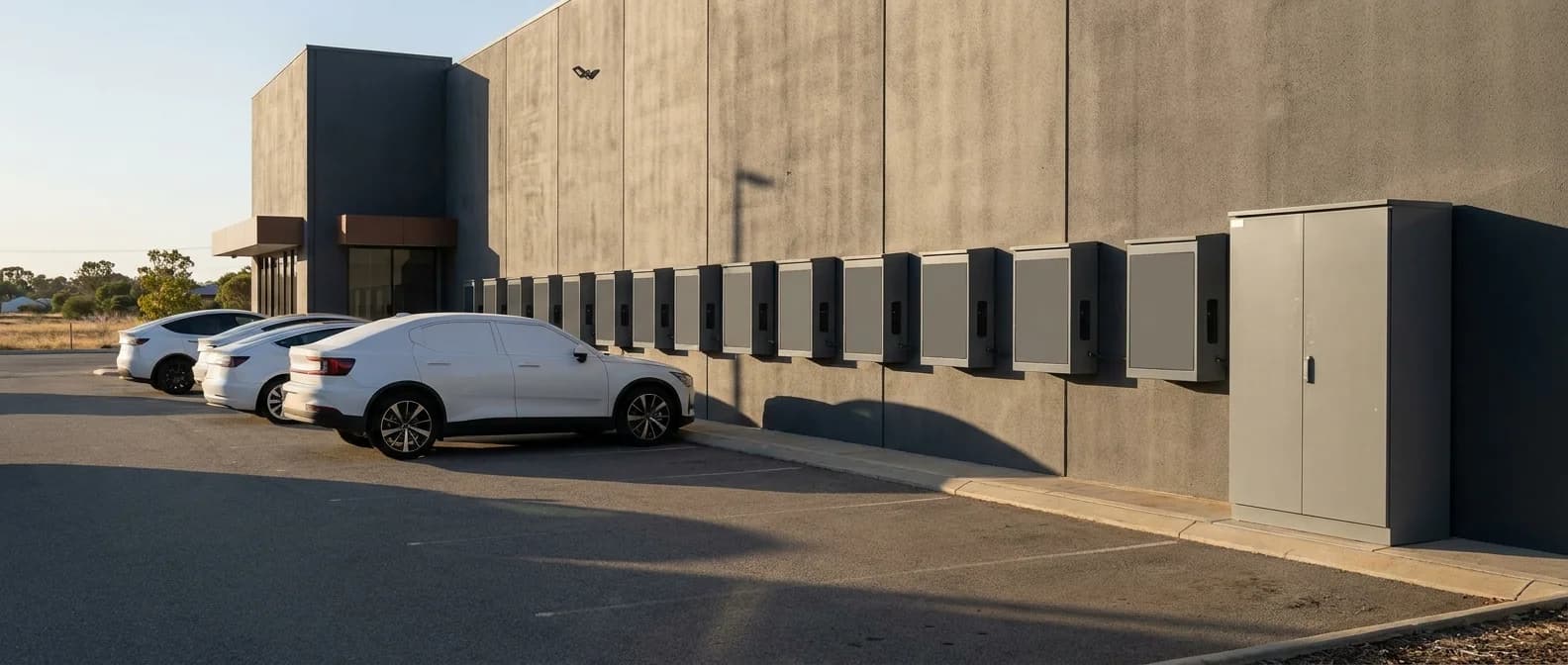

A load management control enclosure beside a commercial switchboard in Perth
Approach
Brand agnostic, not locked to one vendor
Balances
Across chargers and against building load
Typical result
No service upgrade required
Software
Exploren

How an EV load management project runs

Five steps, and usually no service upgrade at the end of them.

  1. 01

    Assess

    We measure what the site actually draws today.

  2. 02

    Model

    The building's demand is mapped against the charging demand.

  3. 03

    Proposal

    Control priced against the service upgrade you were quoted.

  4. 04

    Configure

    The chargers are made aware of each other and of the building.

  5. 05

    Verify

    Total draw is held inside the supply you already have.

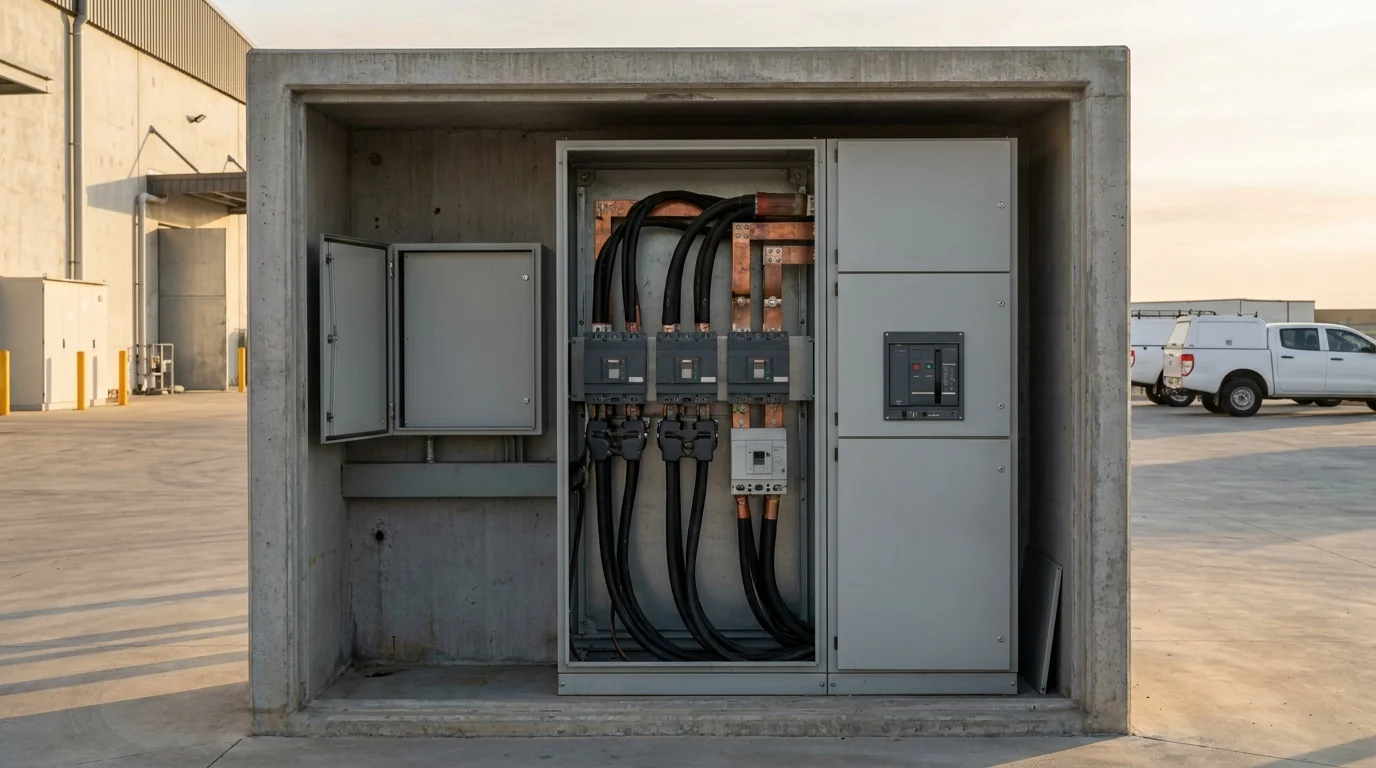

Current transformer clamps on the incoming cables of an open commercial switchboard beside a control enclosure

What a load management project includes

Several electric vans charging at once along a depot wall in the late afternoon

Included

Assessment of the site's real demand

Building load modelled against charging

Proposal priced against the upgrade quote

Configuration across every charger on site

Works with the chargers already there

Verification that the supply holds

Book a site assessment

We look at the supply before anything is quoted. 2 years on parts and labour.

Six cars, one supply, and time to spare.

Dwell time

Six cars sharing one supply

Six cars sharing one supply: plugged in from 7:30am to 5pm, 9.5 hrs in total, of which 4 hrs is spent charging, leaving 5.5 hrs spare.

Plugged in
9.5 hrs
Actually charging
4 hrs
Spare
5.5 hrs

Sharing the supply stretches the charge, and the window swallows it.

What a supply upgrade actually costs in Perth

Worth knowing

Load management exists because network capacity is priced. For a Perth metro site within 25 km of a zone substation, Western Power's published rate to upgrade supply is $496 per kVA, with a capital contribution tax of 13.9 per cent on top. Check the current figure with them before you budget on it.

That is the number the whole decision turns on. Sharing a supply across chargers is a controller and configuration; buying more supply is a per kVA charge, a network application and a wait. We test the first before anyone quotes the second.

Source: Western Power, the network operator for Perth and regional WA.

Load management questions

Questions

Tap a question to open it.

01

Will load management slow the charging down?

It shares the available power, so a vehicle may draw less at peak. In practice it does not matter, because vehicles are parked for far longer than they need to charge. What it prevents is the site tripping or an upgrade being required.

02

Does it lock us into one brand of charger?

No. Our approach is deliberately brand agnostic, so you are not committed to a single manufacturer for the life of the site.

03

How does it know what the rest of the building is using?

A meter on the incoming supply. The system reads the site's total demand and gives the chargers whatever headroom is left, in real time rather than on a schedule.

04

What happens if the internet drops?

The balancing keeps working, because it runs locally rather than depending on a server somewhere. What you lose is the reporting until the connection returns, not the charging.

05

Can we give some vehicles priority?

Yes. A vehicle on an early start can be set to charge first, with the rest sharing what is left. On a depot that is usually more useful than raw speed.

06

How much does it add to the cost?

Less than the supply upgrade it avoids, which is the comparison that matters. The exact figure depends on the number of bays and the hardware, and it is a separate line in the proposal so you can see it.

07

Does it work with solar?

It can, and on a site with a decent array it is worth designing for. Charging can be pushed toward the middle of the day when the system is exporting, which turns a daytime carpark into the best place for that energy to go.

08

Will the network operator need to approve anything?

Some connections do need sign off and some do not, and it depends on the size of the installation and your existing supply. We tell you which one you are at the site visit, before it becomes a surprise.

Let us look at your site.

We assess the supply, the vehicles and the timeline, then put an itemised proposal in front of you.

Call usSite assessment
